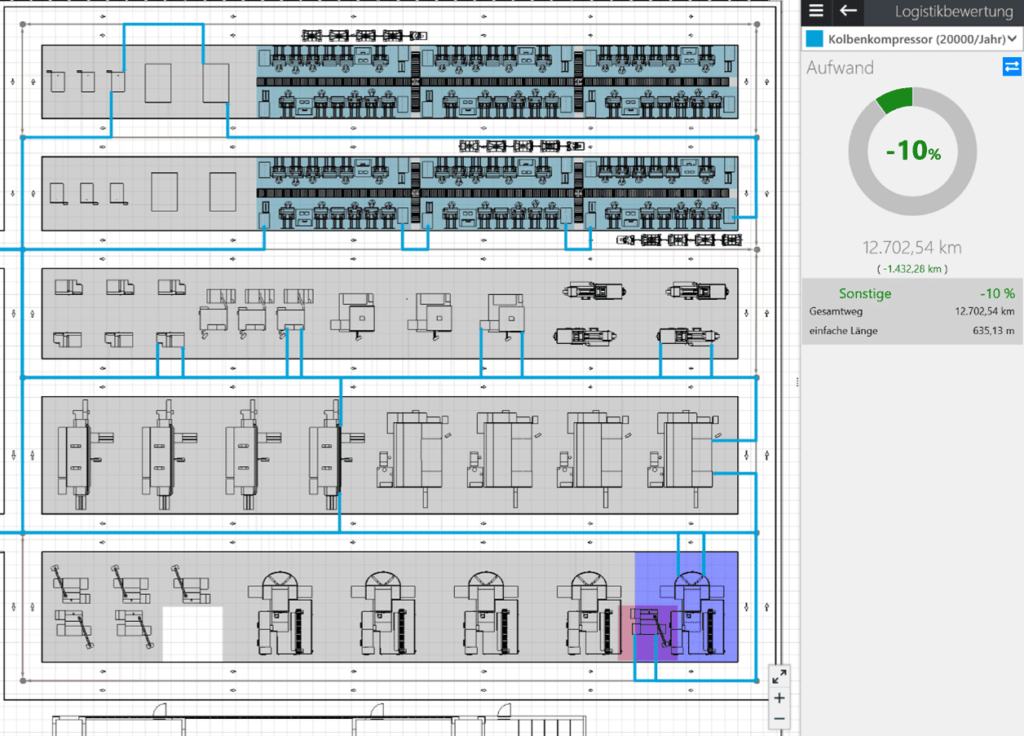

Designing future-state flow systems requires consistent quantities, relationships, spatial constraints and control principles.
Material flow planning means designing future-state flow systems for goods and their associated information. It connects quantities, sources, destinations, load carriers, routes, handling, storage, space and control rules so that alternatives can be compared on one consistent basis.
VDI 2498 Part 1 provides methodological guidance for this design task; VDI 2689 complements it with investigation and process-analysis methods.
When is future-state design the right task?
- Greenfield: a new plant, warehouse or production area needs an end-to-end target structure.
- Expansion: additional products or volumes require new capacity and revised interfaces.
- Brownfield transformation: a fundamental re-layout changes routes, buffers, equipment or control.
- Technology decision: manual, conventional and automated alternatives must be compared against the same requirements.
Inputs and system boundary
The design basis should state products, quantities, frequencies, peak factors, source-destination relationships, load carriers, process sequences, service targets, shift calendars and restrictions. Layout, fire protection, ergonomics, building grids and expansion areas constrain the solution. Assumptions and data confidence belong in the model, not in an informal side note.
From requirements to a preferred concept
- Clarify the planning case: define objective, horizon, boundary and evaluation criteria.
- Create the relationship model: reconcile demand with sources, destinations, periods and handling units.
- Develop principles: separate ideal relationships from spatial and technical constraints.
- Build real variants: combine layout, transport, storage, buffers and control into feasible alternatives.
- Dimension and compare: calculate performance, space, equipment, investment, operating cost and risk.
- Detail the selected system: document interfaces, responsibilities, implementation stages and verification criteria.
Deliverables for a traceable decision
A useful result contains more than a route drawing. It includes the quantity and relationship model, design assumptions, evaluated variants, preferred layout, equipment and buffer principles, performance evidence, interfaces, cost range and an implementation roadmap. Dynamic simulation is added when variability, queues, dispatching rules or shared resources materially affect the decision.
Distinction from analysis and improvement
An analysis establishes the evidence and identifies causes. Existing-system optimization prioritizes measurable interventions in a running operation. Future-state design is broader: it creates and selects an overall target system. Bross Consulting combines analysis, optional simulation within the integrated service and implementation-oriented flow improvement on one project page while retaining the technical definitions in the glossary.
Material flow planning in practice: Our services overview brings together the relevant planning and consulting approaches.
